Upcoming Projects



Chili Bar Renovations

Chili Bar Put-In, located in Placerville, is currently undergoing renovations. The extent of these upgrades is yet to be determined, as the County is investigating the infrastructure.

Project Updates:

  • January 27, 2026: Board approved Amendment II to the Lebeck Engineering contract to extend the expiration date an additional year. (Legistar item #26-0070.) The Chili Bar project is currently on hold as staff seek grant funding to move forward with a site plan option.
  • July 22, 2025: Board provided direction to explore grant opportunities to seek funding for the site plan options developed by Lebeck Engineering for Chili Bar (Legistar item #25-1148.)
  • April 17, 2025: Board reallocated General Fund discretionary funding for the Chili Bar project back to County operations during the FY25-26 budget development process (Legistar item #25-0747.)
  • July 16, 2024: Board approved Amendment I to the Lebeck Engineering contract to include Industrial Relations requirements (Legistar item #24-0716.)
  • February 6, 2024: Board received an update on Chili Bar, and authorized contracting out to Lebeck Engineering, Inc. for civil engineering work to evaluate the site and provide four preliminary development options with site plans and cost estimates (Legistar item #24-0198.)

El Dorado Trail

View the Department of Transportation's trail projects update page for information on trail projects. El Dorado County Transportation Commission also has an Active Transportation current projects page with updates on trail projects.

Forebay Park Renovations

Forebay Park, located in Pollock Pines, is a 12-acre park currently undergoing renovations. El Dorado County acquired the park in 2014 from the El Dorado Irrigation District.

Forebay Park Open House on Saturday, 12/5/26 from 10:00am to 12:00pm, at Forebay Park, 5581 Gail Drive, Pollock Pines. Stop by anytime to learn more about the Forebay Park Improvement Project, hear the latest project updates, and share your ideas. There will be refreshments and kids' activities. All ages are welcome and encouraged to participate! We hope to hear from you! Download the Forebay Park Open House outreach flyer to help spread the word.(PDF, 2MB)

Project Updates

  • April 29, 2026: California State Parks announced recommended projects for the Land and Water Conservation Fund (LWCF) grant program to improve outdoor recreation for communities across California. El Dorado County's Forebay Park Improvement Project was selected as one of 18 local park projects that will protect 2,800 acres for outdoor recreation. The recommended project proposes $1.4 million for improvements to the 14-acre Forebay Park in Pollock Pines. The project will be going through National Park Service review and approval before final award. Check out the State Parks news release for LWCF recommended grant funding and the County's press release announcing the recommended grant.
  • August 5, 2025: A grant application was submitted to the Land and Water Conservation Fund grant program to seek funding for the Forebay Park project phases 2-3. Selected applicants will be notified in February 2026.
  • July 22, 2025: Board provided direction to pursue grant opportunities to seek funding for the project (Legistar item #25-1148).
  • April 22, 2025: Board directed funding in the FY 2025-26 Recommended Budget for project phase 1.
  • August 21, 2024: Community meeting was held to present project updates and next steps (presentation slide deck(PDF, 4MB)).
  • July 2024: Civil engineer firm commenced preparing the engineering plans and construction costs.
  • June 2024: Civil engineer prepared the schematic site master plan and playground concept.
  • January 23, 2024: Contract executed with civil engineering firm to provide phase 1 schematic planning and civil engineering design services.

Forebay Park Site Schematic Master Plan

Forebay Park Master Plan Concept 2024.6.19.png

Project Background

  • November 6, 2023: Community meeting held to discuss the park project and phased plan, and receive a presentation from the Pollock Pines People Playground.
  • September 12, 2023: Board adopted the Initial Study/Mitigated Negative Declaration and approved a phasing plan.
  • December 13, 2022: Board approved second amendment to agreement with Helix Environmental Planning, Inc. to prepare the CEQA initial study.
  • October 18, 2022: Board approved the Forebay Park conceptual design and directed staff to proceed with the environmental review process and develop a phasing plan based on available funding and community priorities.
  • August 18, 2022: Parks and Recreation Commission approved the Forebay Park conceptual design and authorized the CEQA process.
  • August 3, 2022: The ad-hoc committee appointed by the Parks and Recreation Commission met to make recommendations on the bubble diagram.
  • July 27, 2022: The revised bubble diagram from the first public meeting was discussed at the Parks and Recreation Commission.
  • May 18, 2022: A survey was sent out at the end of March 2022 and results were compiled to develop a bubble diagram which was presented at the first public meeting to solicit feedback. The bubble diagram was revised based off the first public meeting input.
  • May 10, 2022: Board approved amendment to agreement with Helix Environmental Planning, Inc. to conduct design work and environmental studies.
  • November 9, 2021: Board allocated $3 million of American Rescue Plan Act (ARPA) Funding for Forebay Park renovations.
  • September 21, 2021: Board approved the Parks and Water Bond Act of 2018 (Prop 68) Per Capita Grant Program project funding to fund the restroom replacement.
  • March 23, 2021: Board authorized submittal of a Parks and Water Bond Act of 2018 (Prop 68) Per Capita Grant Program application to fund the restroom replacement.
  • June 25, 2019: Board authorized submittal of a Parks and Water Bond Act of 2018 (Prop 68) Grant Program application for site renovations and improvements. The grant was not awarded.
  • September 28, 2015: Community meeting held to discuss park priorities, improvements, facilities, and park name.
  • June 2, 2015: Community meeting held to identify park priorities and improvements, and to discuss facilities and park name.

Phase 1 Proposed Renovations

  • Improved entrance and parking lot
  • Accessible pathways
  • ADA accessible restrooms
  • Inclusive playground
  • Senior exercise equipment

Archived Environmental Documents

Forebay Park Conceptual Phased Plan

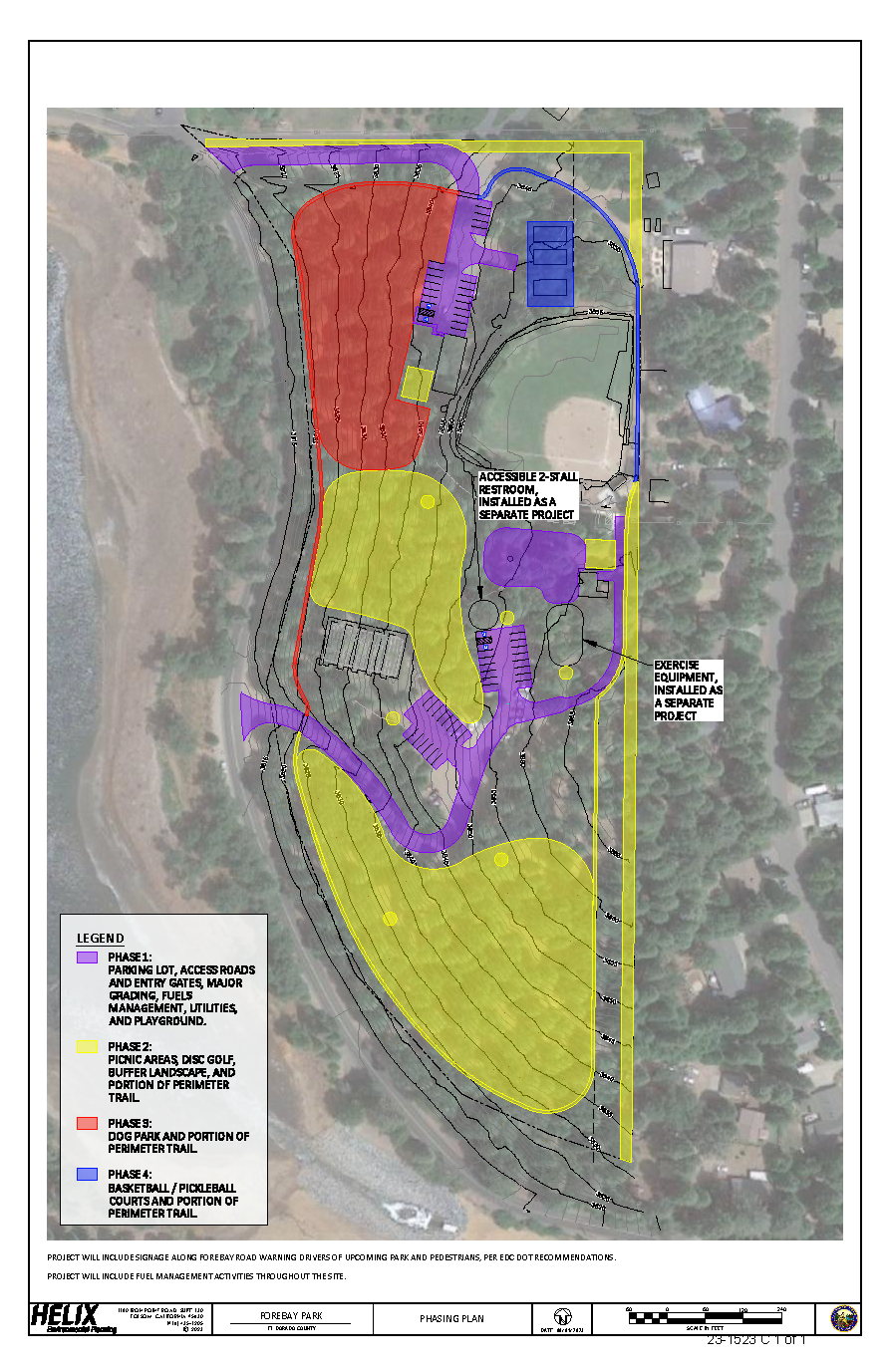

Forebay Park Phasing Plan.png

Henningsen / Lotus Road Trail

Visit the Department of Transportation's trail project page for updates on the Henningsen / Lotus Road Class I Multi-Use Trail Project.

Diamond Springs Community Park

The County has begun planning the development of Diamond Springs Community Park. A concept has been approved by the Board of Supervisors, which includes ball fields, soccer fields, basketball courts, an accessible playground, restrooms, and a picnic area.

Project Updates:

  • March 11, 2025: Board adopted the Addendum to the Diamond Springs Park Final Environmental Impact Report certified in December 2023, and adopted Ordinance 5225 for Rezone Z24-0005 (Legistar item #25-0244.)
  • January 23, 2025: Planning Commission held a hearing to consider the Diamond Springs Park Rezone (Z24-0005) request to rezone two residentially zoned parcels to Recreation Facilities, High-Intensity (RFH) for use as a community park (Legistar item #25-0070.)
  • January 7, 2025: Board authorized entering into contract with Kimley-Horn and Associates, Inc. to provide planning and engineering services for the development of Diamond Springs Park (Legistar item #24-1763.)
  • June 18, 2024: Board adopted Resolution of Intent #108-2024 to amend Title 130 of the County Zoning Ordinance for the development of Diamond Springs Park.
  • May 21, 2024: Board adopted Resolution #081-2024 to declare the property as exempt surplus land per Government Code Sections 54220-54234.
  • February 27, 2024: Board authorized entering into negotiations with the Boys and Girls Club to transfer the property to the Boys and Girls Club for the purpose of developing a park in Diamond Springs.
  • December 12, 2023: Board approved the Final Environmental Impact Report, formally accepted the donation of property identified as APN 331-400-002, and directed staff to move the project forward.
  • September 20, 2022: Board received a presentation of the preliminary design and community input for Diamond Springs Community Park, and approved Design Option B.
  • March 22, 2022: Board authorized entering into contract with Dudek to prepare the Environmental Impact Report for Diamond Springs Community Park.
  • January 25, 2022: Board accepted the donation of property identified as APN 331-400-002 for the purpose of developing a sports complex in the community of Diamond Springs.

Archived Environmental Documents:

Approved Concept for Diamond Springs

Master Plan Update

The Parks and Trails Master Plan update was approved by the El Dorado County Board of Supervisors on March 25, 2025. See the Parks and Trails Master Plan page for details.
